Construction Progress

Current finishes, delivery closeout, and verified construction history.

Current progress

Toronto Tower is in the final construction and completion phase. Current site work focuses on obra blanca: flooring, kitchen cabinetry, lighting, ceiling services, bathroom finishes, elevator/access readiness, utilities, and final delivery closeout.

Target full delivery: mid-September 2026.

The structural phase is documented separately on the Timelapses page.

Where the project is now

Toronto Tower has moved from structural work into final finishes. The structural phase is documented in the timelapse chapters; the current Progress page focuses on obra blanca and delivery closeout.

Project status at a glance

Structure closed

Obra negra and obra gris are closed and documented through the timelapse chapters.

Final finishes underway

Current work is focused on flooring, kitchens, lighting, ceiling services, bathrooms, and final apartment details.

Delivery closeout next

Remaining work includes final installation, utilities, elevator/access readiness, cleaning, documentation, and handover preparation.

Target delivery

Target full delivery remains mid-September 2026.

Progress gallery

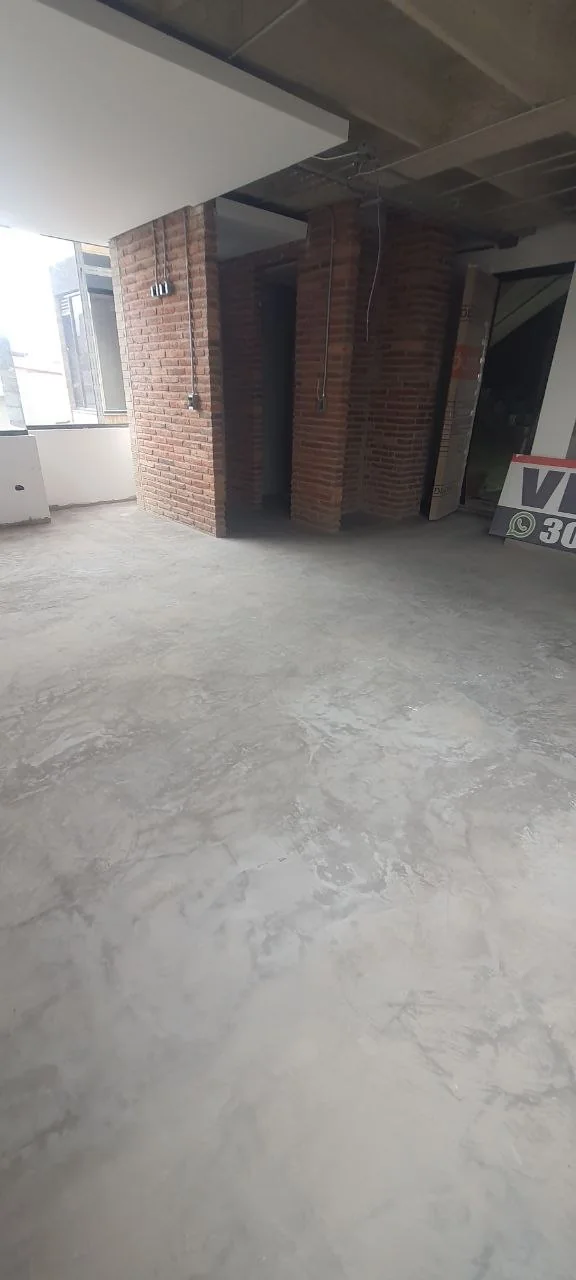

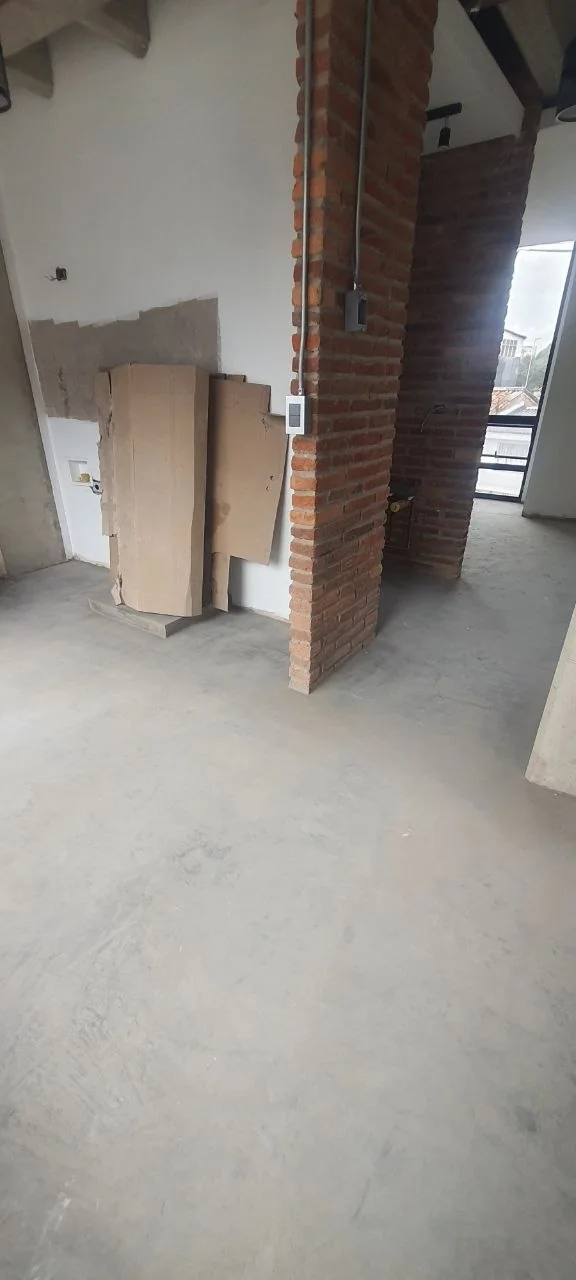

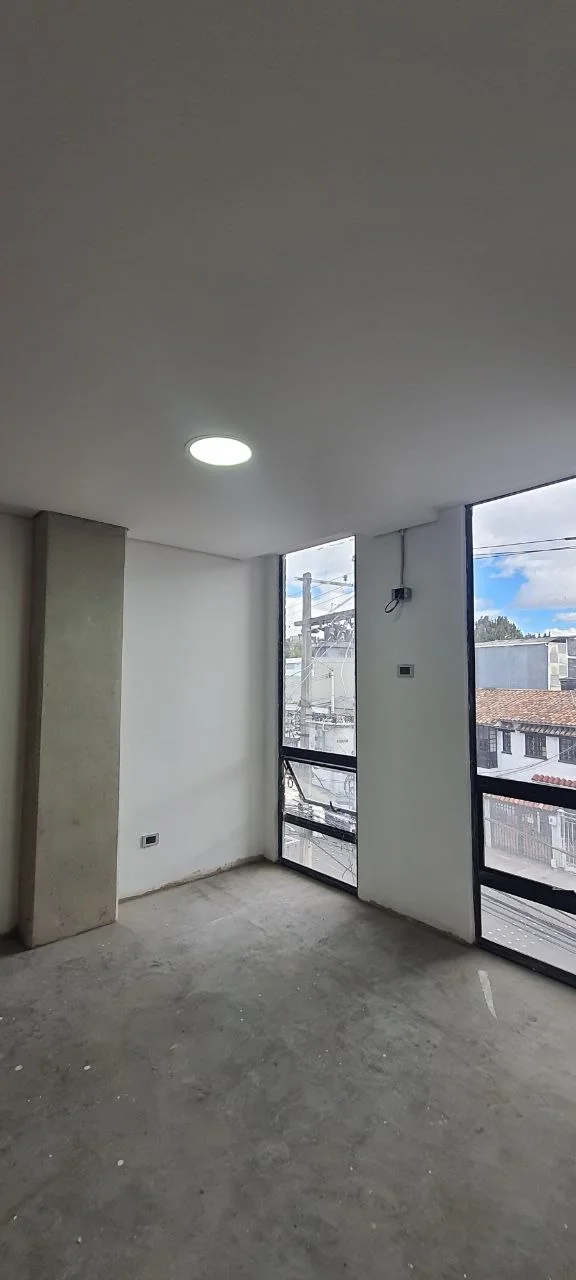

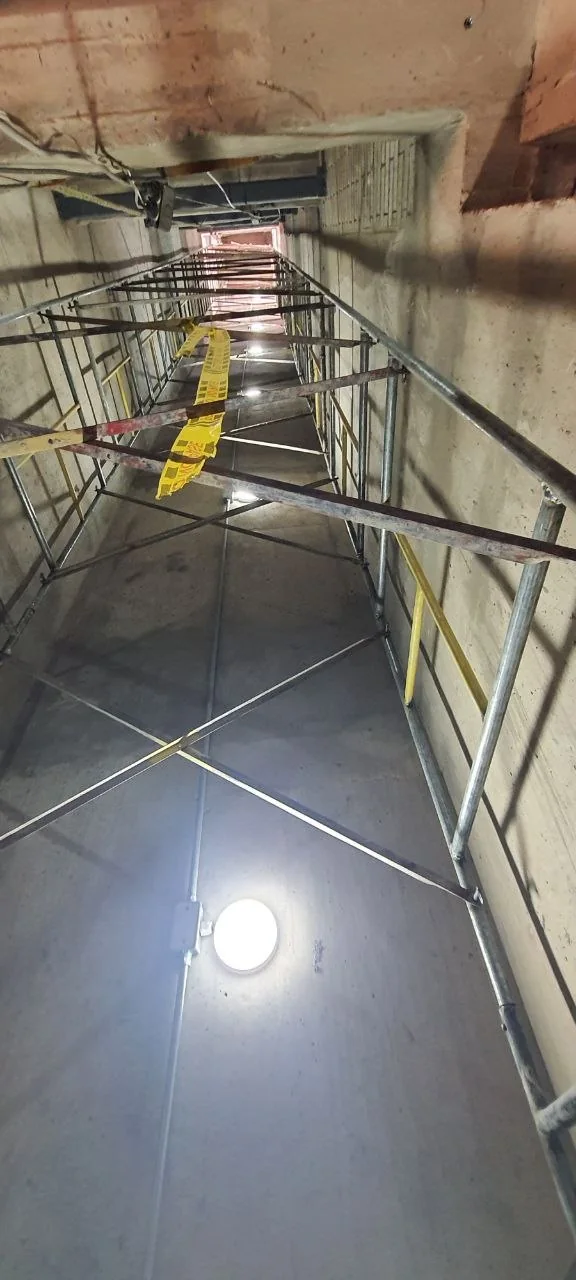

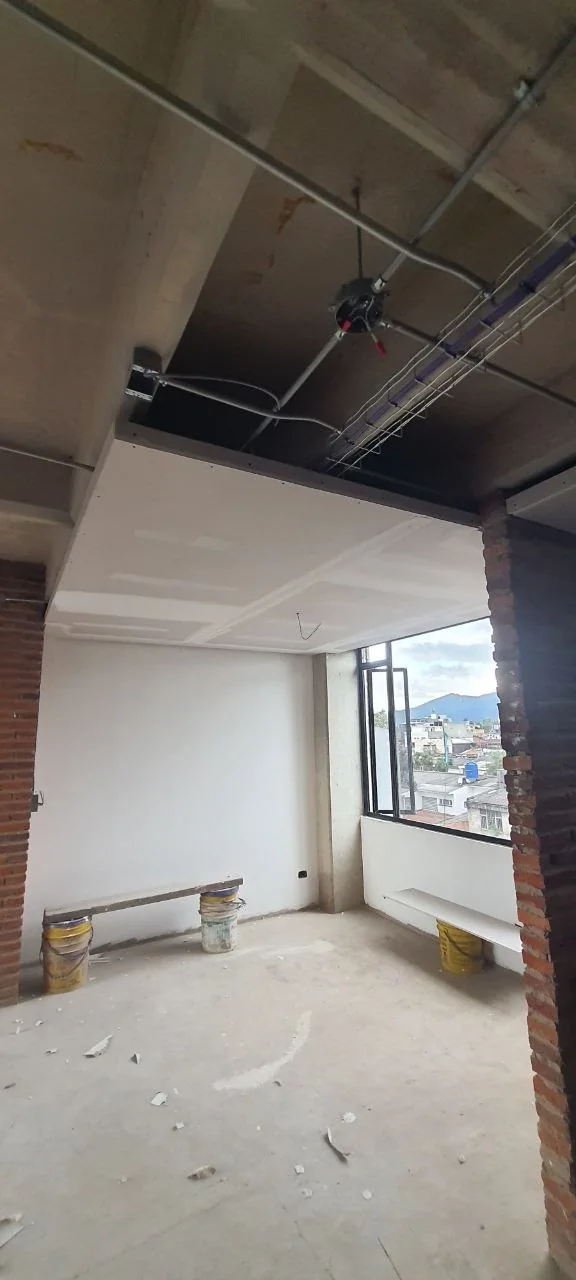

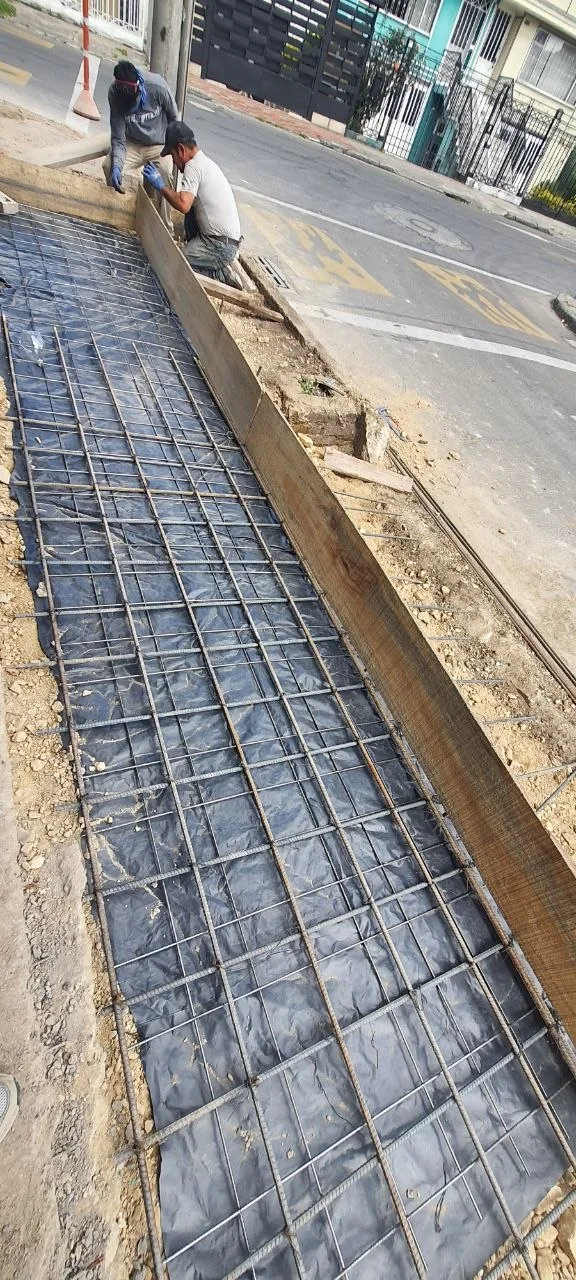

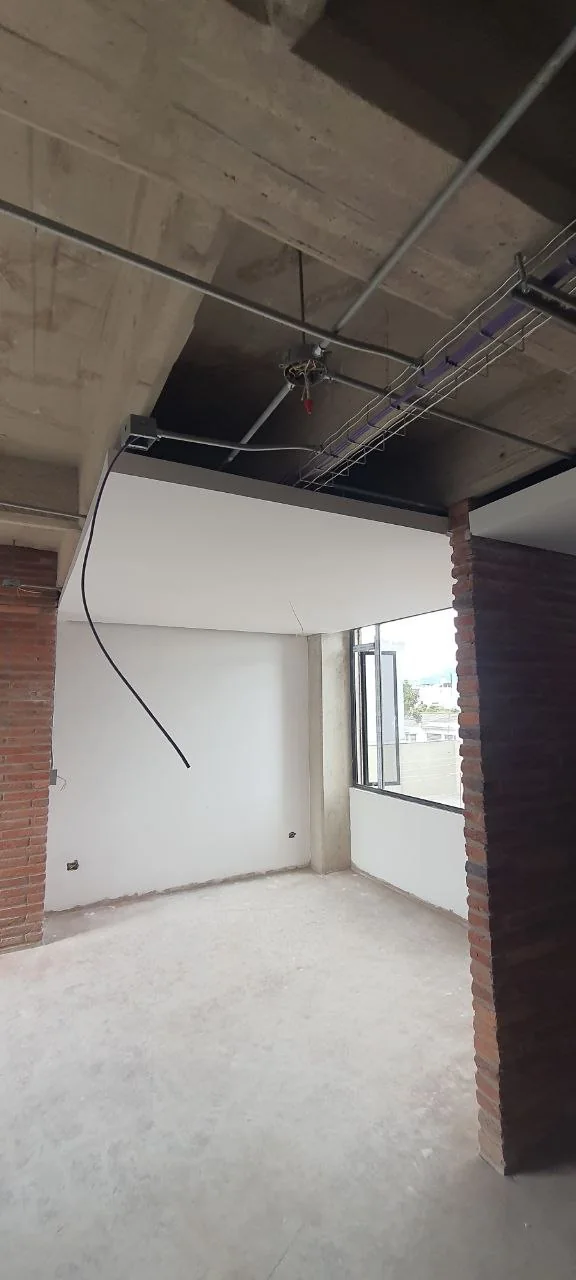

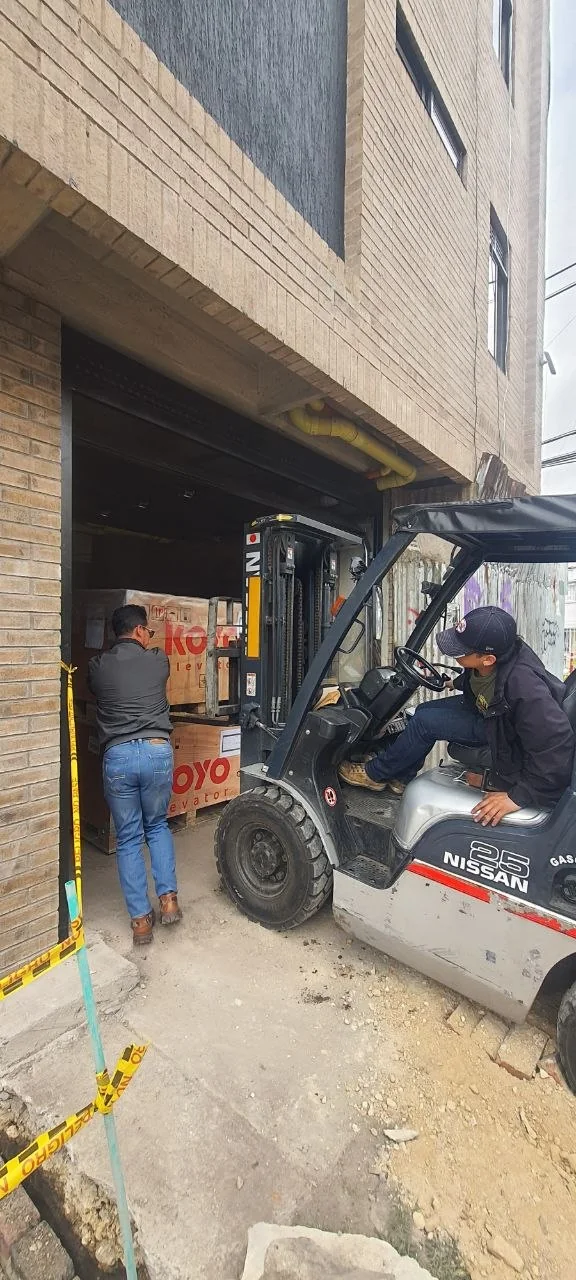

Recent site photos from July 6–9. These are construction-progress photos, not final delivery photos.

Simplified public timeline. Based on project baseline, construction media, and current site progress. Internal schedule fields may not reflect latest on-site progress.

Obra negra / structure

Mar–Sep 2025

Closed

Structural work from foundation to rooftop was completed and is documented on the Timelapses page.

Closed: September 2025. No remaining public structural items.

Watch timelapses

Obra gris / building shell

Sep 2025–Apr 2026

Closed

Building shell, masonry, principal rough-ins, facade preparation, waterproofing, and base-building work were completed during this phase.

Closed: April 2026. Any remaining touch-ups are included under final finishes and closeout.

Obra blanca / finishes

Jun–Sep 2026

Active now

Current phase: flooring, kitchens, closets, lighting, ceilings, bathrooms, and apartment finishing details.

Remaining: Final installation, touch-ups, cleaning, quality assurance, and delivery closeout.

Elevator / vertical access

Jul–Sep 2026

In progress

Elevator installation and vertical-access readiness form part of the final building closeout.

Remaining: Installation completion, testing, and certification.

Utilities and delivery closeout

Jul–Sep 2026

Pending / in progress

Meters, pumps, data and network items, final fixtures, inspections, and the handover package.

Remaining: Final approvals, inspections, and delivery documentation.

Target full delivery

Mid-Sep 2026

Target milestone

Target delivery window for the completed building, subject to final completion and applicable approvals.

Obra negra / structure

Closed

Mar–Sep 2025

Structural work from foundation to rooftop was completed and is documented on the Timelapses page.

Closed: September 2025. No remaining public structural items.

Watch timelapses Obra negra / structure ran from Mar–Sep 2025 and is closed on the public timeline.

Obra gris / building shell

Closed

Sep 2025–Apr 2026

Building shell, masonry, principal rough-ins, facade preparation, waterproofing, and base-building work were completed during this phase.

Closed: April 2026. Any remaining touch-ups are included under final finishes and closeout.

Obra gris / building shell ran from Sep 2025–Apr 2026 and is closed on the public timeline.

Obra blanca / finishes

Active now

Jun–Sep 2026

Current phase: flooring, kitchens, closets, lighting, ceilings, bathrooms, and apartment finishing details.

Remaining: Final installation, touch-ups, cleaning, quality assurance, and delivery closeout.

Obra blanca / finishes runs from Jun–Sep 2026. Status as of July 2026: Active now.

Elevator / vertical access

In progress

Jul–Sep 2026

Elevator installation and vertical-access readiness form part of the final building closeout.

Remaining: Installation completion, testing, and certification.

Elevator / vertical access runs from Jul–Sep 2026. Status as of July 2026: In progress.

Utilities and delivery closeout

Pending / in progress

Jul–Sep 2026

Meters, pumps, data and network items, final fixtures, inspections, and the handover package.

Remaining: Final approvals, inspections, and delivery documentation.

Utilities and delivery closeout runs from Jul–Sep 2026. Status: Pending / in progress.

Target full delivery

Target milestone

Mid-Sep 2026

Target delivery window for the completed building, subject to final completion and applicable approvals.

Target full delivery is mid-September 2026, subject to final completion and applicable approvals.

Timeline is simplified for buyers. Target delivery remains mid-September 2026 and is subject to final completion, sales documentation, and applicable approvals.

Target delivery

Target full delivery: mid-September 2026.

Target full delivery remains mid-September 2026. The remaining work is focused on final installation, utility closeout, elevator/access readiness, documentation, cleaning, and handover preparation.

Interior reference renders

These interior reference renders show design direction only. Final finishes, furniture, equipment, and specifications are subject to final confirmation and sales documentation.

Furniture is not included. Reference renders show design direction only.

Reference render — kitchen with dining bar
Reference render — final finishes subject to confirmation.
Reference render — living area with large window
Reference render — final finishes subject to confirmation.
Reference render — industrial-style bedroom concept
Reference render — final finishes subject to confirmation.
Reference render — living/study concept
Reference render — final finishes subject to confirmation.

Construction timelapses

Foundation-to-rooftop timelapse chapters from the obra negra phase (March–September 2025) are on a dedicated page so they stay easy to browse.

Watch Timelapses

Revit/BIM updates

The Revit/BIM public viewer link is being renewed. Buyers can request current visuals and project information directly while the public link is prepared.
